Tue, Jul 14

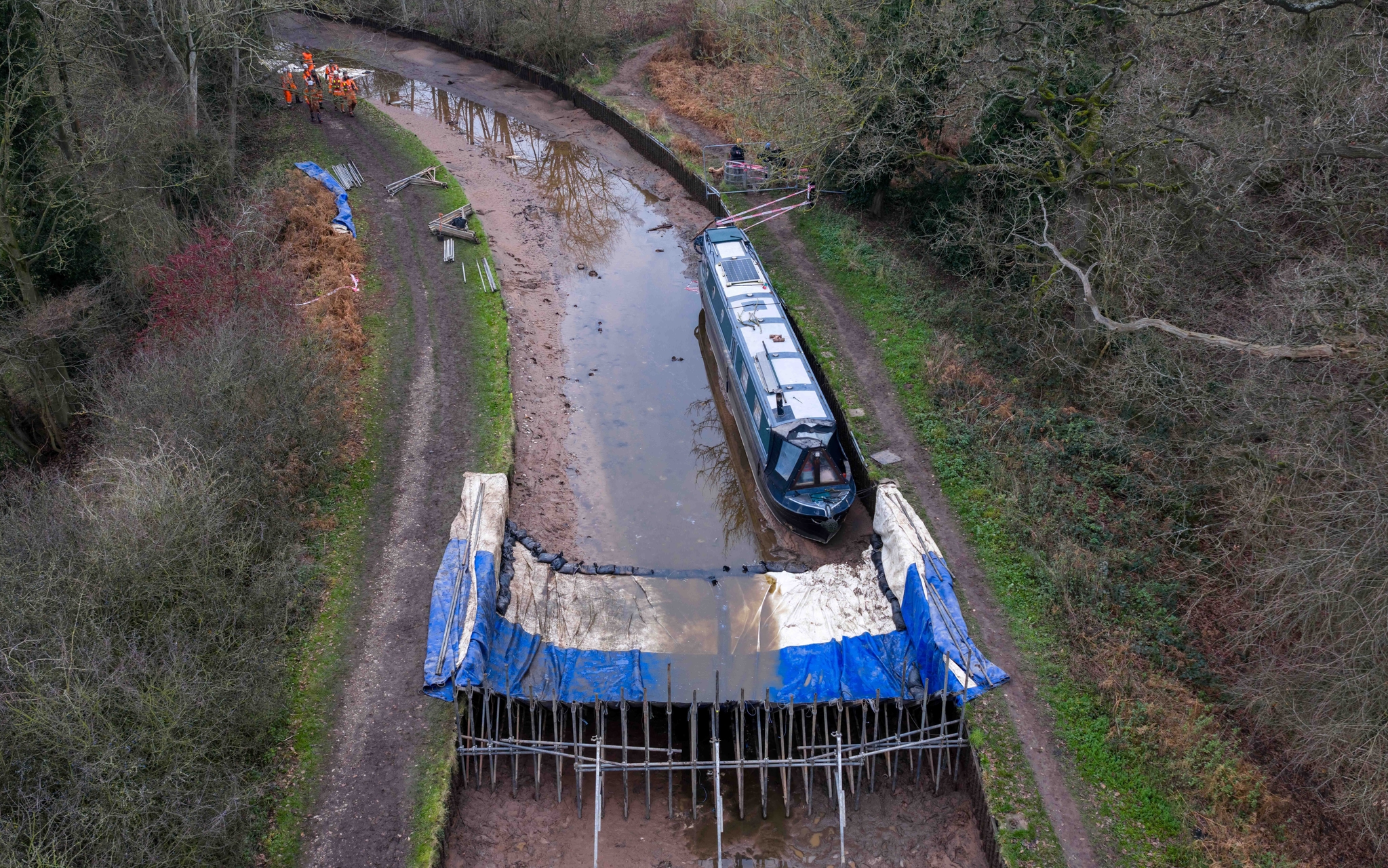

We have completed the reprofiling and reinstatement of the flooded field using material recovered from the site and are now installing land drains and applying topsoil.

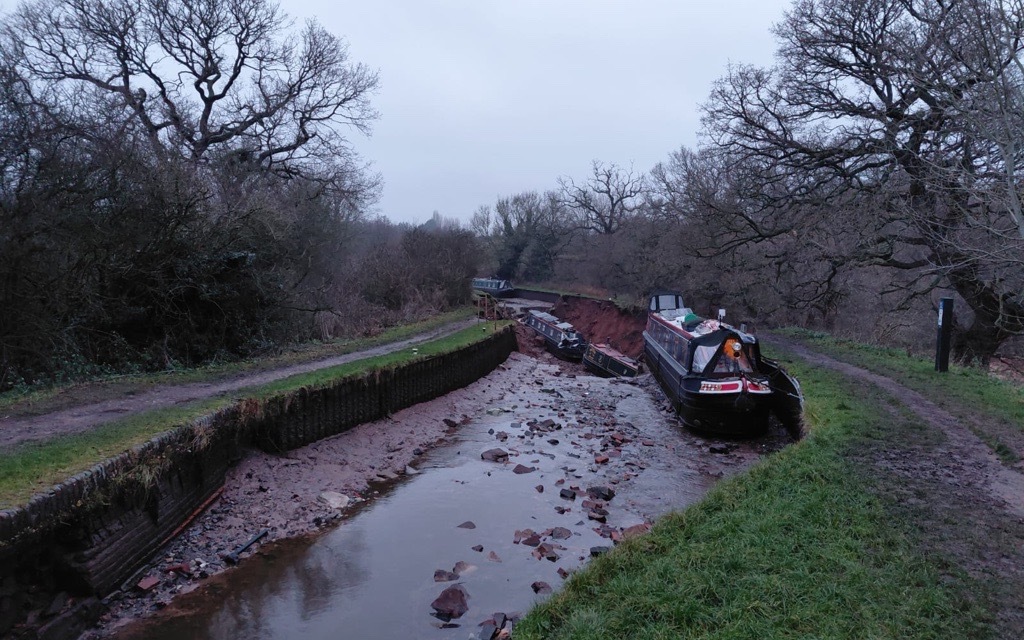

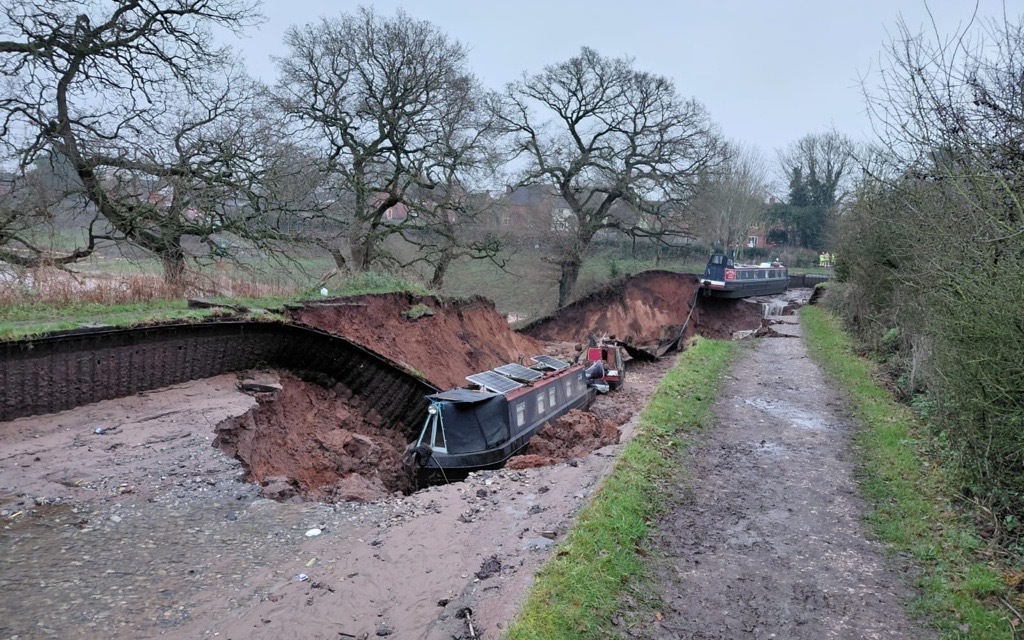

Once work within the flooded field is complete, expected by the end of this week, we will begin reconstruction of the embankment. Laboratory testing has shown that the material recovered from the site contains too high a clay content to be suitable for reuse. As a result, imported granular material will be used in conjunction with a polymer geogrid to form the new embankment.
The design of the concrete channel is still being finalised, and further details will be provided once they become available.

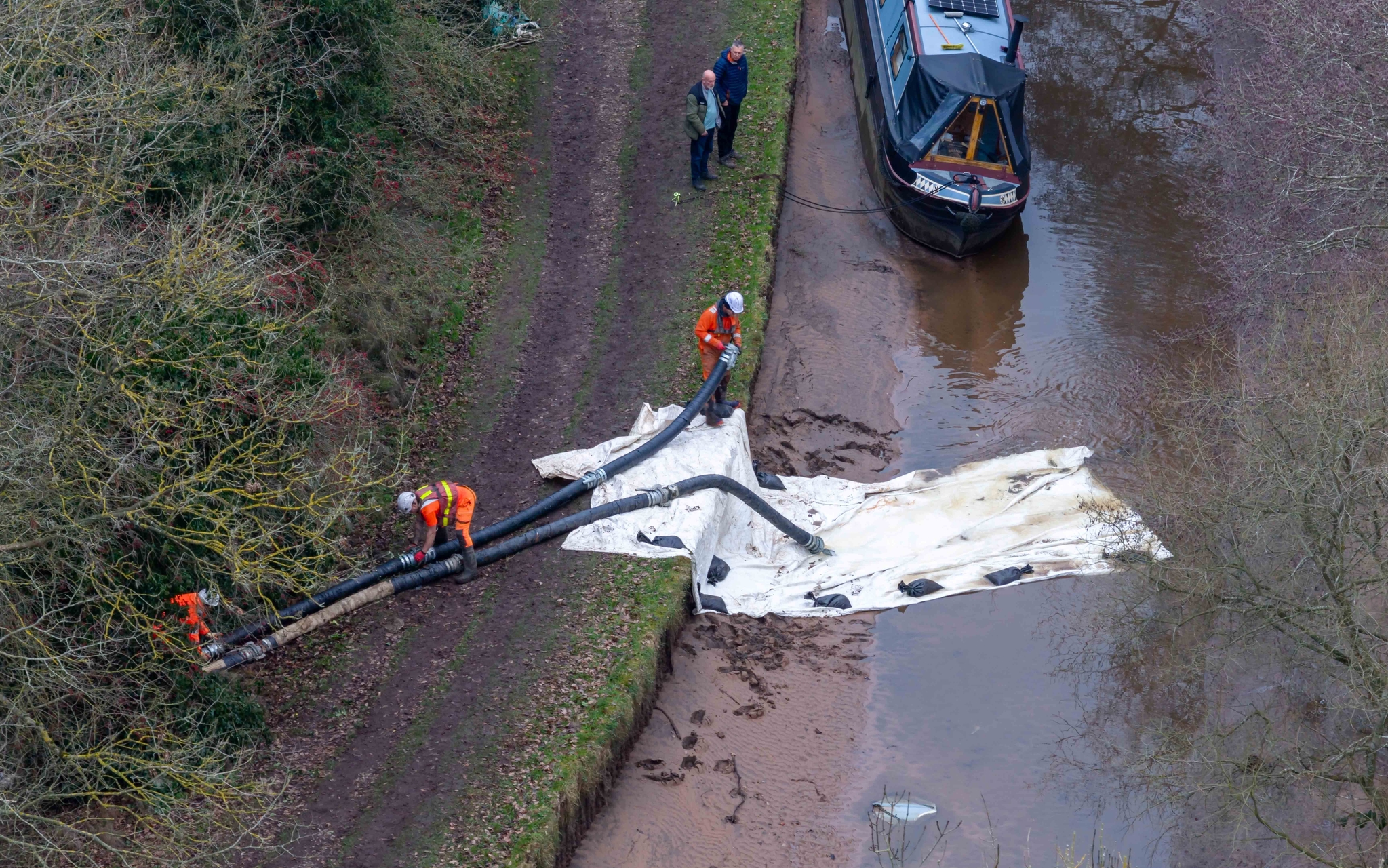

Water continues to be pumped around the breach. Additional pumps are being installed to provide greater resilience and increased pumping capacity. We will continue to provide updates as work progresses.
